Installation Timeline for a Concrete Batching Plant

Release Time: 2025-11-18
Read: 365
Share:

Ⅰ. Core Factors Influencing Installation Duration

Before analysing the timeline, we must first understand the key factors determining progress:

1. Plant Type and Structural Complexity

  • Fixed Plants (RUNH HZSG/HZSD/HZS Series): It involves numerous structural components with complex underpinnings, leading to extended installation periods.
  • Mobile Plants (RUNH HZSY Series): Most modules are pre-assembled, requiring only crane-assisted assembly, thus saving considerable time.
  • Quick-assembly (RUNH HZSK series): Simple frame structure with fully modularised transport, enabling the fastest installation.

2. Foundation Construction Conditions

Foundation pouring, rebar tying, and embedded part placement typically require 1–3 weeks. Duration may extend during rainy seasons or on soft ground.

3. Site Accessibility and Lifting Conditions

Road access, site dimensions, crane capacity, and power supply availability all impact installation speed.

4. Plant Scale and Configuration

  • Whether equipped with cement silos, multiple conveyors, aggregate bins, admixture systems, dual-mixer stations, etc.
  • Highly automated plants require extended commissioning periods for electrical and control systems.

Ⅱ. Complete Installation Timeline (From Preparation to Commissioning)

The following timescales represent industry benchmarks, subject to ±20% variation based on site conditions.

Phase 1: Preliminary Preparation (1–4 weeks)

Extensive preparatory work is essential prior to formal installation, critical for ensuring subsequent construction proceeds smoothly.

1.1 Approvals and Permits

Apply for building permits, environmental approvals, etc., from local authorities. Depending on regional policies, this may take 1–4 weeks.

1.2 Site Survey and Design Confirmation (3–7 days)

  • Conduct site measurements and finalise layout plans
  • Confirm foundation designs and production line flow diagrams
  • Plan water supply, electrical, and drainage systems

1.3 Foundation Construction (1–3 weeks)

  • Earthworks excavation and foundation bedding
  • Reinforcement/formwork / concrete pouring
  • Embedded parts and anchor bolt positioning
  • Aggregate pit and discharge platform pouring

Deep foundations for large fixed stations (≥120 m³/h) extend the construction duration.

1.4 Utility Layout (5–10 days)

  • Power connection (transformer, distribution box)
  • Water supply piping
  • Air supply system (air compressor room, embedded air pipes)

If foundations are complete and site conditions are favourable, the entire preparation phase may be compressed to one week; otherwise, it may extend to over one month.

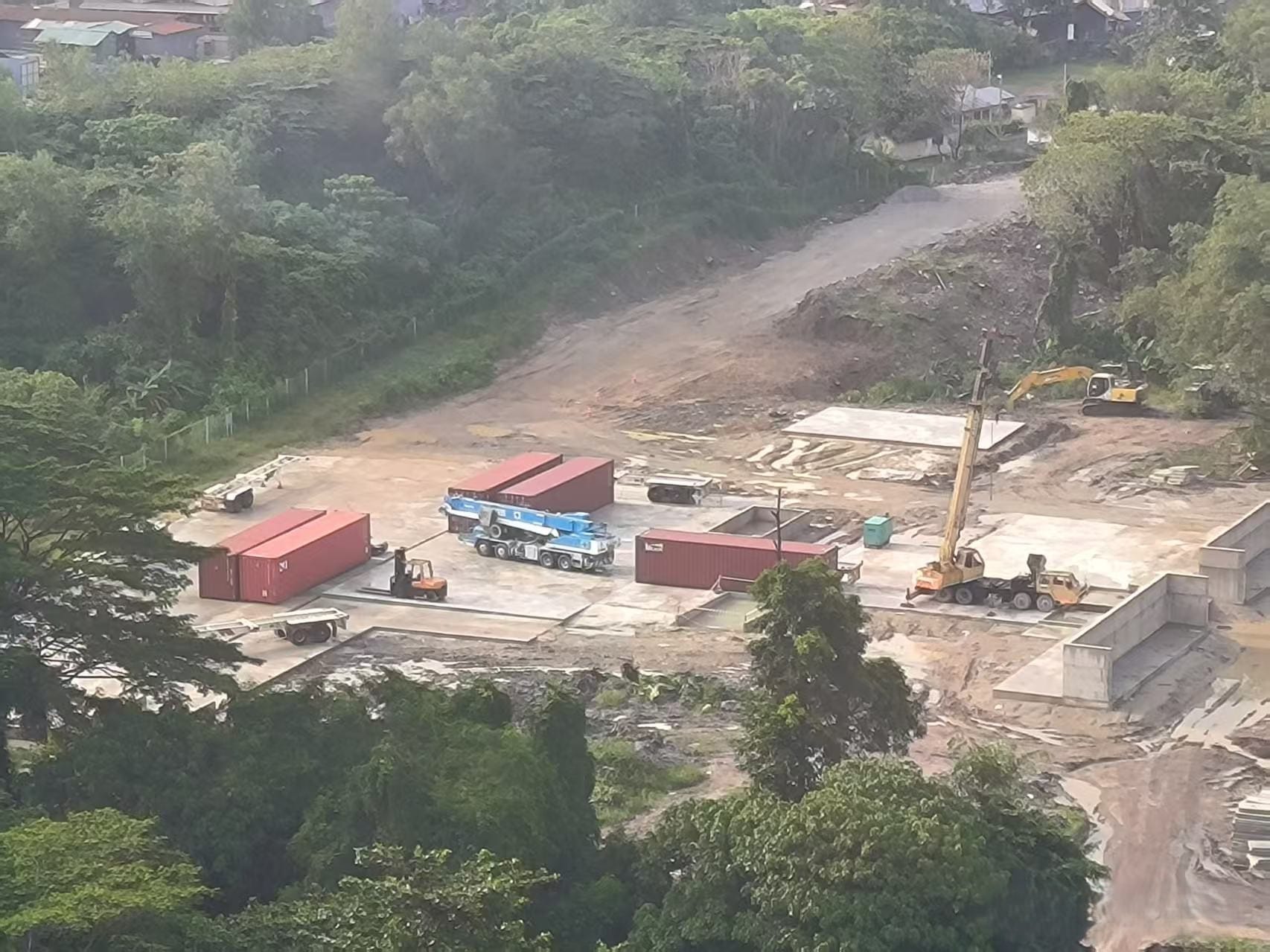

Phase 2: Equipment Transportation and Delivery (1–4 weeks)

Transportation times vary significantly, with typical scenarios as follows:

  • Local/Domestic Suppliers: Delivery usually takes 3–7 days.
  • International Transport (Sea Freight): Generally requires 2–4 weeks (excluding customs clearance time).

Phase 3: On-site Installation (2–6 weeks)

This constitutes the core phase, involving the assembly of four major components: civil works, steel structures, equipment, and electrical systems.

3.1 Steel Structure and Frame Installation (5–15 days)

  • Main mixing plant structural framework
  • Aggregate batching machine
  • Aggregate conveyor belts
  • Cement silos and screw conveyors
  • Inclined belt supports, main station platform

Lifting operations primarily utilise 25–50 tonne cranes.

3.2 Main Mixer and Hopper System Installation (3–7 days)

  • Installation of twin-shaft mixer / planetary mixer / vertical shaft mixer
  • Connecting reducers, discharge gates, and weighing systems
  • Installing cylinders, sensors

Main unit installation requires strict calibration of levelness and shaft alignment to ensure equipment stability.

3.3 Electrical and Automation System Installation (5–10 days)

  • Control cabinet and operator cabin layout
  • Connecting sensors and limit switches
  • Cable laying
  • PLC and weighing system wiring
  • Formula storage and logic testing

Large automated plants involve extensive on-site wiring, extending the timeline slightly.

3.4 Pneumatic/Hydraulic System Installation (3–7 days)

  • Pneumatic piping
  • Air compressor connection
  • Hydraulic discharge system (if applicable)
  • Adjustment of air-water separators and pressure relief valves

Naturally, installation periods extend for large concrete plants (e.g., capacity exceeding 100 m³/h), whereas mobile or compact batching plants feature shorter installation times due to extensive pre-assembly of modules.

Phase 4: Commissioning and Trial Operation (7-10 days)

Commissioning constitutes the critical phase for ensuring compliance with production output, quality standards, and weighing accuracy.

4.1 Individual Equipment Commissioning (1–3 days)

Includes:

  • Aggregate batcher weighing calibration
  • Cement and powder weighing calibration
  • Water and admixture system verification
  • Empty-load testing of the mixing main unit

4.2 Full Line Interlocking Commissioning (2–5 days)

  • Interconnection of all systems
  • PLC programme logic testing
  • Emergency protection testing
  • Actual trial mixing (concrete discharge slump and uniformity testing)

4.3 Operator Training (2–5 days)

Typically includes:

  • Control system operation
  • Routine maintenance procedures
  • Common fault troubleshooting
  • Safety precautions

III. Comparison of Total Construction Periods for Different Types of Concrete Batching Plants

The total installation and commissioning time varies significantly depending on the type and scale of the mixing plant. Below is a reference for the industry standard time frame for RUNH’s commonly available models:

Equipment Type Common Capacity Installation Cycle
Mobile Concrete Batching Plant 25–60 m³/h 1-2 weeks

 (can commence production in as little as 7–10 days)

Quick-install Concrete Batching Plant 50–120 m³/h 1-2 weeks

(can commence production in as little as 7 days)

Engineering Concrete Batching Plant 60–120 m³/h 2-3 weeks
Large Commercial Concrete Batching Plant 120–240 m³/h 3-5 weeks
Dual-purpose/Customized Concrete Batching Plant 150–300+ m³/h 6-8 weeks or more

Ⅳ. Key Factors Affecting Installation Progress

In practical engineering projects, the following factors significantly impact progress:

  • Weather Conditions

Rainy days, high temperatures, or extreme weather slow the construction pace.

  • Labour Force and Technical Proficiency

Experienced, skilled installation teams operate more efficiently.

  • Equipment Customisation Level

Highly automated, complex configurations (e.g., advanced PLC control systems) require extended installation and commissioning periods.

  • Site Foundation Conditions

Pre-prepared foundations (e.g., pre-poured footings) can save considerable time.

Ⅴ. How to Shorten Installation Duration? (Professional Recommendations)

As equipment manufacturers or engineering contractors, RUNH typically assists clients in accelerating installation through the following measures:

1. Advance Review of Foundation Construction Drawings

Minimises construction rework and misaligned embedded components.

2. Modular Pre-assembly of equipment

For instance, pre-assembling the main building frame, mixers, and inclined belt supports can save 20%–40% of on-site time.

3. Ensuring Smooth on-site Logistics and Lifting operations

Optimise crane, forklift, and unloading route planning.

4. Advance Planning for Utilities

Many project delays stem from delayed electrical connections.

5. Dispatch Experienced Installation Engineers from the Manufacturer

A professional team significantly enhances safety and efficiency.

Conclusion: How long does it take to install a concrete batching plant?

Under normal circumstances, the process for a concrete batching plant—from preliminary preparation, delivery, and installation to commissioning—typically takes anywhere from several weeks to several months, depending on the equipment type and project scale.

For RUNH’s compact or mobile plants, installation can generally be completed within 3 to 7 days once the site has undergone ground hardening and the necessary ground levelling and drainage works have been completed. Fixed large-scale plants require approximately 2 to 3 weeks.

Effective preliminary planning (foundation preparation, utility connections, permit processing, etc.), an experienced installation team, and robust supply chain management are key to accelerating the schedule.

(Tips: The above installation timeline is theoretical. Actual construction periods may vary based on site conditions, equipment configurations, and any customized requirements. If you need a tailored solution or a more precise installation estimate, feel free to contact us. Our team will provide a professional assessment and the most efficient installation plan for your project.)
